San Diego Miramar College Lighting Inverters

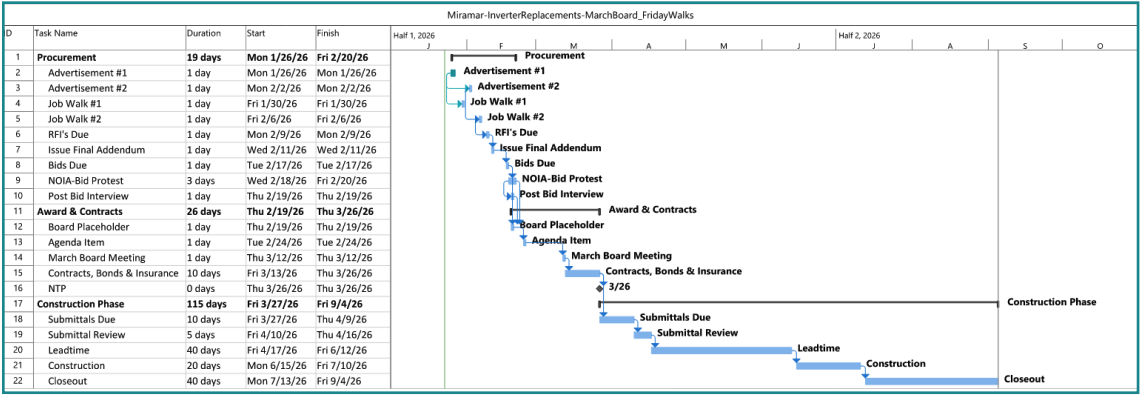

Project Schedule
| Programming Complete | Design and DSA Approval | Construction Completion (Est.) | FFE and Move-In (Est.) |
|---|---|---|---|
| 12-2025 | N/A | TBD | N/A |
Current Status/Phase:
Project Progress Update
Inverters identified in 9 building are slated for like-in-kind replacement. The scope for this project includes remove existing inverters, including batteries. The work will remove and replace lighting control inverters at Buildings J, P-1, K-2, G-4, H, N, S-6, G-3, and C-2 at Miramar College campus.
Upcoming Milestones:
- Contractor Bids Due: Tuesday, February 17, 2026 by 2pm via Planet Bids.
- Contractor Bid Award to Ready Electric: Thursday, March 12, 2026.
- Construction kickoff scheduled: Friday, March 27, 2026.
- Construction completion expected late Q3/Q4 2026.
Project Features
Lighting Inverters Replacement:
- Inverters identified in 9 building structures are slated to be replaced like-in-kind.
- The contractor shall remove existing inverters as part of their scope of work, including associated batteries.
- The contractor shall provide all labor and materials necessary to remove and replace nine (9) lighting control inverters at the following buildings: J, P-1, K-2, G-4, H, N, S-6, G-3, and C-2.

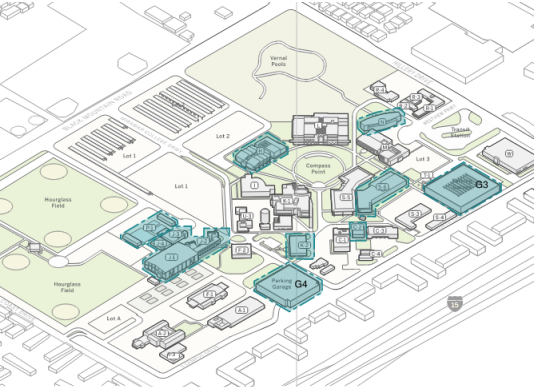

Project Map

10440 Black Mountain Rd, San Diego, CA 92126
Project News & Information
Additional resources, articles, and links related to this project will appear here when available. For comprehensive information about Measure HH and all ongoing projects, please explore the Measure HH website.
Project Teams
| General Contractor | Ready Electric |
| Architect | McParlane & Associates |
| Structural Engineer | N/A |
| Civil Engineer | N/A |
| Mech./ Elect. Engineer | N/A |
| Executive Const. Manager | Steve Evanco |
